title: The US data center buildout is falling behind schedule:
description: "Nearly 40% of US data center projects due to complete in 2026 are AT RISK of missing their deadlines by more than 3 months, according to SynMax satellite analysis and IIR Energy data.\n\nMore than 60% of projects scheduled for 2027 have yet to begin construction as of April 2026.\n\nThe 2027 pipeline alone represents ~50 gigawatts of planned capacity, equivalent to the output of ~50 nuclear reactors, with the majority still showing no construction activity, according to SynMax Vulcan Platform and IIR Energy.\n\nThe primary constraints are chronic shortages of specialist labor, gas turbines, and transformers, along with permitting hurdles that are pushing labor costs up as much as +30% in remote locations.\n\nIs the US data center 'boom' hitting the wall?\n\nSource: Global Markets Investor, FT"
image: https://blog.syzgroup.com/hubfs/7-Apr-22-2026-01-53-22-1817-PM.jpg
---

[![Syz Private banking](https://blog.syzgroup.com/hs-fs/hubfs/Logo.png?width=140&name=Logo.png "Syz Private banking")](https://www.syzgroup.com/fr)

## **Thinking** out loud

[Subscribe](https://25733253.hs-sites-eu1.com/newsletter-signup?hsLang=en)

[![Contact Us](https://hubspot-no-cache-eu1-prod.s3.amazonaws.com/cta/default/25733253/3d762f49-4e71-4f99-97b1-bf6781ef3da2.png)](https://hubspot-cta-redirect-eu1-prod.s3.amazonaws.com/cta/redirect/25733253/3d762f49-4e71-4f99-97b1-bf6781ef3da2)

- [OUR SERVICES](https://www.syzgroup.com/en/private-banking)
- [ABOUT SYZ](https://www.syzgroup.com/en/about/welcome-to-syz)
- [CAREERS](https://www.syzgroup.com/en/careers)
- [PRESS](https://www.syzgroup.com/en/news)
- [Blog Homepage](https://blog.syzgroup.com)
    - [Slow Food for Thought](https://blog.syzgroup.com/slow-food-for-thought)
          - [Focus](https://blog.syzgroup.com/slow-food-for-thoughts/tag/focus)
          - [Asset allocations Insights](https://blog.syzgroup.com/slow-food-for-thoughts/tag/asset-allocation-insights)
          - [Market Outlook](https://blog.syzgroup.com/slow-food-for-thoughts/tag/market-outlook)
          - [Swiss Perspectives](https://blog.syzgroup.com/slow-food-for-thoughts/tag/swiss-perspectives)
    - [Syz the moment](https://blog.syzgroup.com/syz-the-moment)
    - [Crypto corner](https://blog.syzgroup.com/crypto-corner)
    - [Syz AI Insights](https://blog.syzgroup.com/syz-ai-insights)
    - [Fast Food for Thought](https://blog.syzgroup.com/fast-food-for-thought)
          - [The week in seven charts](https://blog.syzgroup.com/fast-food-for-thoughts/tag/the-week-in-seven-charts)
          - [Flash](https://blog.syzgroup.com/fast-food-for-thoughts/tag/flash)
          - [Fixed Income Weekly](https://blog.syzgroup.com/fast-food-for-thought/tag/weekly-fixed-income)
          - [Equity Weekly](https://blog.syzgroup.com/fast-food-for-thought/tag/weekly-equities)
          - [Global markets outlook](https://blog.syzgroup.com/fast-food-for-thoughts/tag/global-markets-outlook)
- [CONTACT](https://www.syzgroup.com/en/contact-us/form)
- [ENGLISH](https://www.syzgroup.com/)
- [FRANÇAIS](https://www.syzgroup.com/fr)

- [Slow Food for Thought](https://blog.syzgroup.com/slow-food-for-thought)
    - [Focus](https://blog.syzgroup.com/slow-food-for-thoughts/tag/focus)
    - [Asset allocations Insights](https://blog.syzgroup.com/slow-food-for-thoughts/tag/asset-allocation-insights)
    - [Market Outlook](https://blog.syzgroup.com/slow-food-for-thoughts/tag/market-outlook)
    - [Swiss Perspectives](https://blog.syzgroup.com/slow-food-for-thoughts/tag/swiss-perspectives)
- [Fast Food for Thought](https://blog.syzgroup.com/fast-food-for-thought)
    - [Flash](https://blog.syzgroup.com/fast-food-for-thoughts/tag/flash)
    - [Weekly Fixed Income](https://blog.syzgroup.com/fast-food-for-thought/tag/weekly-fixed-income)
    - [The week in seven charts](https://blog.syzgroup.com/slow-food-for-thoughts/tag/the-week-in-seven-charts)
    - [Global markets outlook](https://blog.syzgroup.com/fast-food-for-thoughts/tag/global-markets-outlook)
    - [Weekly Equities](https://blog.syzgroup.com/fast-food-for-thought/tag/weekly-equities)
- [Syz the moment](https://blog.syzgroup.com/syz-the-moment)
- [Crypto corner](https://blog.syzgroup.com/crypto-corner)
- [Syz AI Insights](https://blog.syzgroup.com/syz-ai-insights)
- [Our Services](https://www.syzgroup.com/en/private-banking)
- [About Syz](https://www.syzgroup.com/en/about/welcome-to-syz)
- [Careers](https://www.syzgroup.com/en/careers)
- [Press](https://www.syzgroup.com/en/news)
- [Contact](https://www.syzgroup.com/en/contact-us/form)
- [English](https://www.syzgroup.com/)
- [Français](https://www.syzgroup.com/fr)

## **Sign-up** for our newsletter

 This website uses cookies to enhance user navigation and to collect statistical data. You can change your settings below to refuse the use of cookies. For more information, please refer to the [Cookies policy](https://www.syzgroup.com/en/legal-notices).

 Mandatory cookies

 Functional cookies

 Statistics & marketing

I confirm I am not a US citizen residing in the US

I confirm I am not accessing this site from the US

I confirm that I am not a resident of Canada (except for Ontario, Quebec, British Columbia or Alberta).

Agree and confirm

### Restricted access

We are sorry that for legal reasons we are not able to help US citizens or Canadian residents other than in Ontario, Quebec, or Alberta. Best wishes for the future…

### Restricted access

We are sorry that for legal reasons we are not able to help US citizens or Canadian residents other than in Ontario, Quebec, or Alberta. Best wishes for the future…

You chose the following profile. If you made a mistake, please change here USA

Country

Switzerland Canada: Other than Ontario, Quebec, Alberta Canada: Ontario, Quebec or Alberta USA Other country

Language

Language English French German Italian

I confirm

Legal information

This marketing document has been issued by Bank Syz Ltd. It is not intended for distribution to, publication, provision or use by individuals or legal entities that are citizens of or reside in a state, country or jurisdiction in which applicable laws and regulations prohibit its distribution, publication, provision or use. It is not directed to any person or entity to whom it would be illegal to send such marketing material.

This document is intended for informational purposes only and should not be construed as an offer, solicitation or recommendation for the subscription, purchase, sale or safekeeping of any security or financial instrument or for the engagement in any other transaction, as the provision of any investment advice or service, or as a contractual document. Nothing in this document constitutes an investment, legal, tax or accounting advice or a representation that any investment or strategy is suitable or appropriate for an investor's particular and individual circumstances, nor does it constitute a personalized investment advice for any investor.

This document reflects the information, opinions and comments of Bank Syz Ltd. as of the date of its publication, which are subject to change without notice. The opinions and comments of the authors in this document reflect their current views and may not coincide with those of other
 Syz Group entities or third parties, which may have reached different conclusions. The market valuations, terms and calculations contained herein are estimates only. The information provided comes from sources deemed reliable, but Bank Syz Ltd. does not guarantee its completeness, accuracy, reliability and actuality. Past performance gives no indication of nor guarantees current or future results. Bank Syz Ltd. accepts no liability for any loss arising from the use of this document.

22 Apr 2026

- <https://twitter.com/intent/tweet?url=https://blog.syzgroup.com/syz-the-moment/the-us-data-center-buildout-is-falling-behind-schedule&text=The%20US%20data%20center%20buildout%20is%20falling%20behind%20schedule:>
- <http://www.linkedin.com/shareArticle?mini=true&url=https://blog.syzgroup.com/syz-the-moment/the-us-data-center-buildout-is-falling-behind-schedule&submitted-image-url=https://25733253.fs1.hubspotusercontent-eu1.net/hubfs/25733253/7-Apr-22-2026-01-53-22-1817-PM.jpg&title=The%20US%20data%20center%20buildout%20is%20falling%20behind%20schedule:&summary=Nearly%2040%%20of%20US%20data%20center%20projects%20due%20to%20complete%20in%202026%20are%20AT%20RISK%20of%20missing%20their%20deadlines%20by%20more%20than%203%20months,%20according%20to%20SynMax%20satellite%20analysis%20and%20IIR%20Energy%20data.%20More%20than%2060%%20of%20projects%20scheduled%20for%202027%20have%20yet%20to%20begin%20construction%20as%20of%20April%202026.%20The%202027%20pipeline%20alone%20represents%20~50%20gigawatts%20of%20planned%20capacity,%20equivalent%20to%20the%20output%20of%20~50%20nuclear%20reactors,%20with%20the%20majority%20still%20showing%20no%20construction%20activity,%20according%20to%20SynMax%20Vulcan%20Platform%20and%20IIR%20Energy.%20The%20primary%20constraints%20are%20chronic%20shortages%20of%20specialist%20labor,%20gas%20turbines,%20and%20transformers,%20along%20with%20permitting%20hurdles%20that%20are%20pushing%20labor%20costs%20up%20as%20much%20as%20+30%%20in%20remote%20locations.%20Is%20the%20US%20data%20center%20'boom'%20hitting%20the%20wall?%20Source:%20Global%20Markets%20Investor,%20FT&source=https://blog.syzgroup.com/syz-the-moment/the-us-data-center-buildout-is-falling-behind-schedule>
- <https://www.facebook.com/sharer/sharer.php?u=https://blog.syzgroup.com/syz-the-moment/the-us-data-center-buildout-is-falling-behind-schedule>

#### The US data center buildout is falling behind schedule:

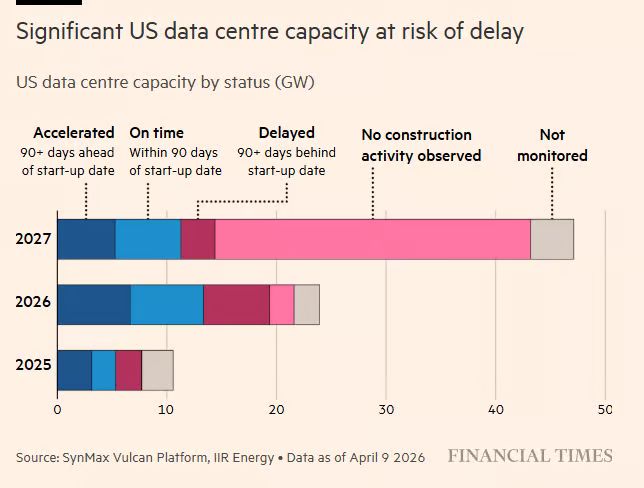

 Nearly 40% of US data center projects due to complete in 2026 are AT RISK of missing their deadlines by more than 3 months, according to SynMax satellite analysis and IIR Energy data. More than 60% of projects scheduled for 2027 have yet to begin construction as of April 2026. The 2027 pipeline alone represents ~50 gigawatts of planned capacity, equivalent to the output of ~50 nuclear reactors, with the majority still showing no construction activity, according to SynMax Vulcan Platform and IIR Energy. The primary constraints are chronic shortages of specialist labor, gas turbines, and transformers, along with permitting hurdles that are pushing labor costs up as much as +30% in remote locations. Is the US data center 'boom' hitting the wall? Source: Global Markets Investor, FT

[#Food for Thought|](https://blog.syzgroup.com/syz-the-moment/tag/food-for-thought) [#AI](https://blog.syzgroup.com/syz-the-moment/tag/ai)

![The US data center buildout is falling behind schedule:](https://blog.syzgroup.com/hubfs/7-Apr-22-2026-01-53-22-1817-PM.jpg)

![The US data center buildout is falling behind schedule:](https://blog.syzgroup.com/hubfs/7-Apr-22-2026-01-53-22-1817-PM.jpg)

#### Disclaimer

This marketing document has been issued by Bank Syz Ltd. It is not intended for distribution to, publication, provision or use by individuals or legal entities that are citizens of or reside in a state, country or jurisdiction in which applicable laws and regulations prohibit its distribution, publication, provision or use. It is not directed to any person or entity to whom it would be illegal to send such marketing material. This document is intended for informational purposes only and should not be construed as an offer, solicitation or recommendation for the subscription, purchase, sale or safekeeping of any security or financial instrument or for the engagement in any other transaction, as the provision of any investment advice or service, or as a contractual document. Nothing in this document constitutes an investment, legal, tax or accounting advice or a representation that any investment or strategy is suitable or appropriate for an investor's particular and individual circumstances, nor does it constitute a personalized investment advice for any investor. This document reflects the information, opinions and comments of Bank Syz Ltd. as of the date of its publication, which are subject to change without notice. The opinions and comments of the authors in this document reflect their current views and may not coincide with those of other Syz Group entities or third parties, which may have reached different conclusions. The market valuations, terms and calculations contained herein are estimates only. The information provided comes from sources deemed reliable, but Bank Syz Ltd. does not guarantee its completeness, accuracy, reliability and actuality. Past performance gives no indication of nor guarantees current or future results. Bank Syz Ltd. accepts no liability for any loss arising from the use of this document.

Read More

## Related Articles

<https://blog.syzgroup.com/syz-the-moment/the-ai-bond-rout-has-now-hit-the-blue-chip-tenants-as-well?hsLang=en>

[Food for Thought|](https://blog.syzgroup.com/syz-the-moment/tag/food-for-thought) [AI](https://blog.syzgroup.com/syz-the-moment/tag/ai)

#### [The AI bond rout has now hit the blue-chip tenants as well.](https://blog.syzgroup.com/syz-the-moment/the-ai-bond-rout-has-now-hit-the-blue-chip-tenants-as-well?hsLang=en)

Meta's Hyperion: 91c. Hut 8's Nvidia-leased sites: 91-93. Microsoft-leased Excalibur: 87. All were sold as the "safe" end of the AI trade. Well, it's now very quickly repricing like the risky end. Source: Nic @puckrin, FT

**[Charles-Henry Monchau, CFA, CMT, CAIA](https://blog.syzgroup.com/author/charles-henry-monchau?hsLang=en)**

|

16/10/2026

<https://blog.syzgroup.com/syz-the-moment/frankfurt-airport-facing-kerosene-shortage.-the-reasons-are-maintenance-of-a-pipeline-and-low-river-water-levels?hsLang=en>

[Food for Thought|](https://blog.syzgroup.com/syz-the-moment/tag/food-for-thought) [oil](https://blog.syzgroup.com/syz-the-moment/tag/oil)

#### [Frankfurt Airport facing kerosene shortage. The reasons are maintenance of a pipeline and low river water levels](https://blog.syzgroup.com/syz-the-moment/frankfurt-airport-facing-kerosene-shortage.-the-reasons-are-maintenance-of-a-pipeline-and-low-river-water-levels?hsLang=en)

Lufthansa is taking steps to address difficulties in sourcing kerosene at Frankfurt Airport, one of Europe’s main air traffic hubs. The German airline has put in place precautionary measures involving the loading of additional fuel on certain flights, with the aim of minimising the need to refuel upon arrival at the German airport. The decision, reported by the German newspaper \*Bild\*, concerns an operational strategy known as ‘tankering’: aircraft carry more fuel than is necessary for the flight they are about to undertake, so as to have a reserve available for the next flight and reduce their reliance on fuel supplies at the destination airport. Lufthansa has stated that, thanks to the measures taken, ‘no flight cancellations are currently planned’. The measures will remain in force until further notice and will be updated as the situation develops.

**[Charles-Henry Monchau, CFA, CMT, CAIA](https://blog.syzgroup.com/author/charles-henry-monchau?hsLang=en)**

|

16/10/2026

<https://blog.syzgroup.com/syz-the-moment/a-railroad-is-like-a-lie-you-have-to-keep-building-to-it-to-make-it-stand.-mark-twain-1867?hsLang=en>

[Food for Thought](https://blog.syzgroup.com/syz-the-moment/tag/food-for-thought)

#### [A railroad is like a lie – you have to keep building to it to make it stand." - Mark Twain, 1867](https://blog.syzgroup.com/syz-the-moment/a-railroad-is-like-a-lie-you-have-to-keep-building-to-it-to-make-it-stand.-mark-twain-1867?hsLang=en)

Source: zerohedge

**[Charles-Henry Monchau, CFA, CMT, CAIA](https://blog.syzgroup.com/author/charles-henry-monchau?hsLang=en)**

|

16/10/2026

## Straight from the Desk

# Syz the moment

Live feeds, charts, breaking stories, all day long.

[Discover more](https://blog.syzgroup.com/syz-the-moment)

## **Thinking** out loud

Sign up for our weekly email highlighting the most popular posts.

Follow us

## **Thinking** out loud

- <https://www.linkedin.com/company/syz-group>
- <https://twitter.com/SYZ_Group>
- <https://www.facebook.com/Syzgroup>
- <https://www.youtube.com/channel/UCqYkMqGRB-DaDaggM8fTW8g>

## **Investing** with intelligence

Our latest research, commentary and market outlooks

#### [Weekly Market Update](https://blog.syzgroup.com/fast-food-for-thoughts/tag/weekly-market-update?hsLang=en)

#### [Focus](https://blog.syzgroup.com/slow-food-for-thoughts/tag/focus?hsLang=en)

#### [Asset Allocation Insights](https://blog.syzgroup.com/slow-food-for-thoughts/tag/asset-allocation-insights?hsLang=en)

#### [Semi-annual Outlook](https://blog.syzgroup.com/slow-food-for-thoughts/tag/semi-annual-outlook?hsLang=en)

- [Contact](https://www.syzgroup.com/en/contact-us/form)
- [Terms & conditions](https://www.syzgroup.com/sites/default/files/document/2021-12/001-2_en-general_terms_and_conditions_w.pdf)
- [Data protection notice](https://www.syzgroup.com/en/data-protection-notice)
- [Cookies policy](https://www.syzgroup.com/en/legal-notices)
- [Syzgroup.com](https://www.syzgroup.com/)

```json
{
  "@context" : "https://schema.org",
  "@type" : "BlogPosting",
  "author" : {
    "@type" : "Person",
    "name" : "Charles-Henry Monchau, CFA, CMT, CAIA",
    "url" : "https://blog.syzgroup.com/syz-the-moment/author/charles-henry-monchau"
  },
  "dateModified" : "2026-04-22T13:53:45.011Z",
  "datePublished" : "2026-04-22T13:53:45.000Z",
  "headline" : "The US data center buildout is falling behind schedule:",
  "image" : [ "https://blog.syzgroup.com/hubfs/7-Apr-22-2026-01-53-22-1817-PM.jpg" ],
  "mainEntityOfPage" : {
    "@id" : "https://blog.syzgroup.com/syz-the-moment/the-us-data-center-buildout-is-falling-behind-schedule",
    "@type" : "WebPage"
  },
  "publisher" : {
    "@type" : "Organization",
    "logo" : {
      "@type" : "ImageObject",
      "url" : "https://blog.syzgroup.com/hubfs/Logo%20(1).png"
    },
    "name" : "Syz Group"
  }
}
```
